Loft

Tutorials/Plan and run a production

Budget AI tokens

AI generation is spent in tokens, and like labour it needs a budget. This tutorial budgets an AI short's tokens from its bid, gives an artist an allowance with a hard limit, then comes back three weeks later to see the spend against the work approved, a forecast at completion, an allowance doing its job, and the tokens in the project's P/L.

Follow along

Step by step

STEP 01

Open the project

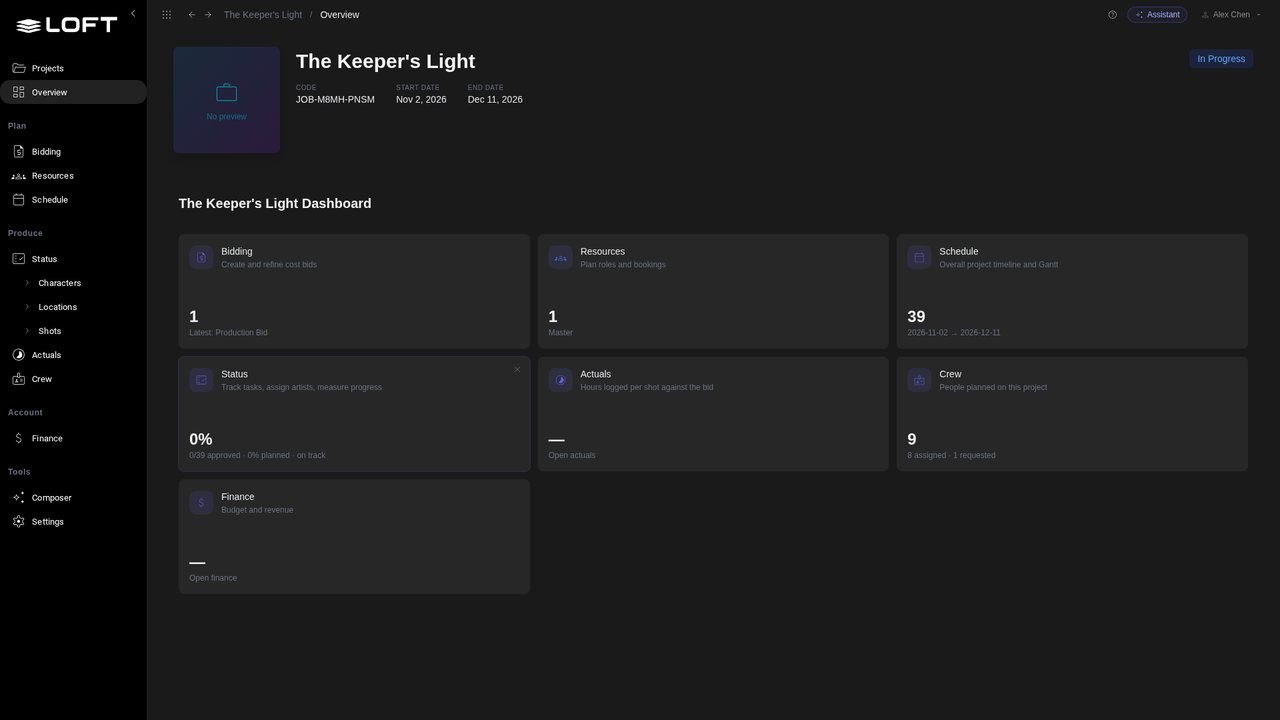

Open The Keeper's Light from the Projects page. It is a six-week AI short at kickoff: the bid is published, the schedule made, the crew booked.

Open the project
STEP 02

Open the bid

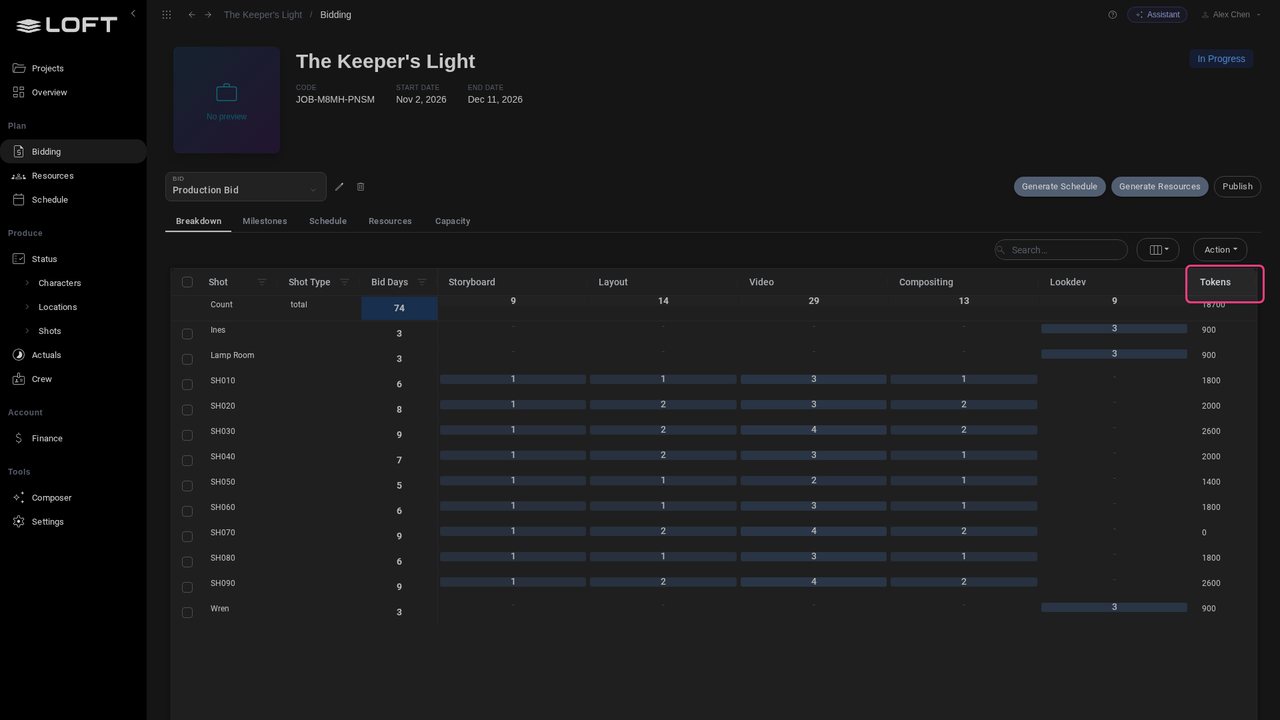

In the sidebar's Plan group, click Bidding. The bid holds the days each shot needs in each department, and next to them, the Tokens each one is expected to spend on AI generation.

Open the bid
STEP 03

Read the Tokens column

Tokens are what generation is charged in. Video takes most: a ten-second take costs 420 tokens, a frame 10 to 25. The Count row adds them up. SH070, the drowned nave, has no estimate yet.

Read the Tokens column
STEP 04

Estimate SH070

Double-click SH070's Tokens cell and type 2800: four days of video, more takes than most. The total becomes 21,500.

Estimate SH070
STEP 05

Publish

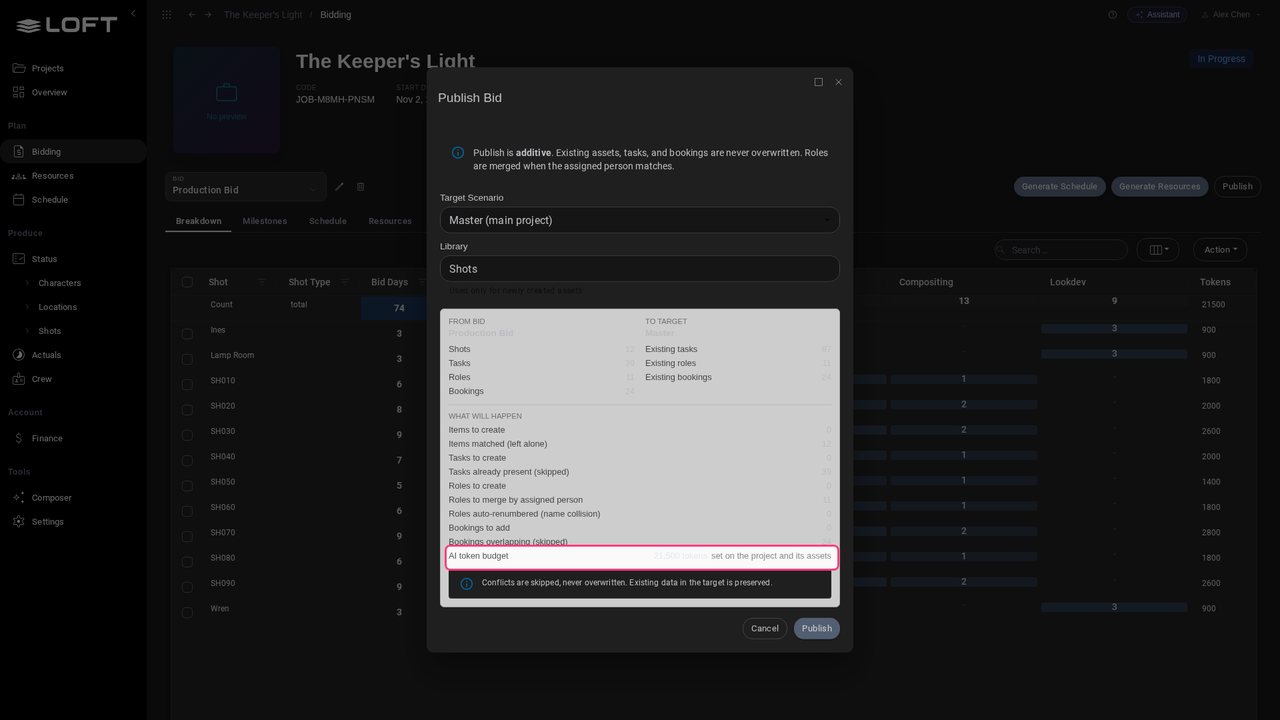

Click Publish, top right. Publishing to Master turns the bid's tokens into budgets: each shot's own, and their sum for the project.

Publish
STEP 06

Confirm

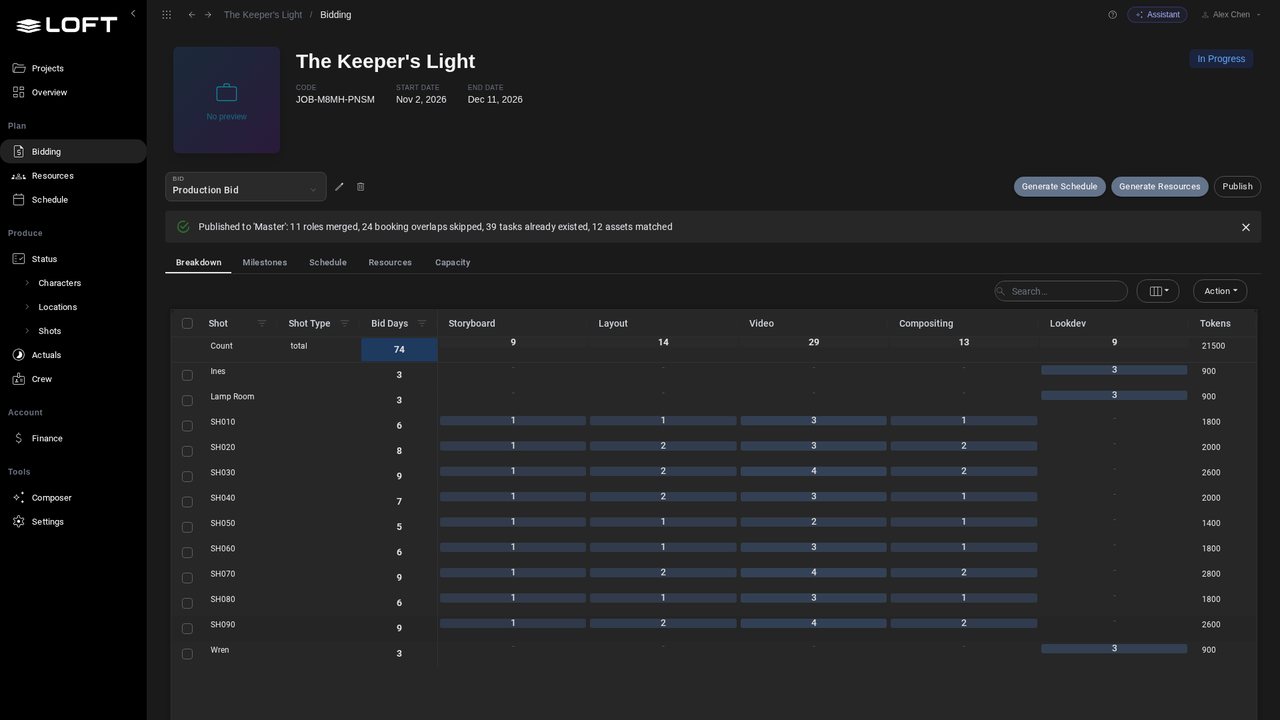

Click Publish in the dialog. The tasks and bookings are already there and stay as they are; the budgets are new.

Confirm
STEP 07

Open Progress

In the Produce group, click Status, then Progress. Next to the schedule, the Tokens card now has a budget to measure against: 21,500 tokens, none spent yet.

Open Progress
STEP 08

Open Costing

Click Set budgets and allowances in Costing. Costing is where the spend is broken down and every budget can be changed.

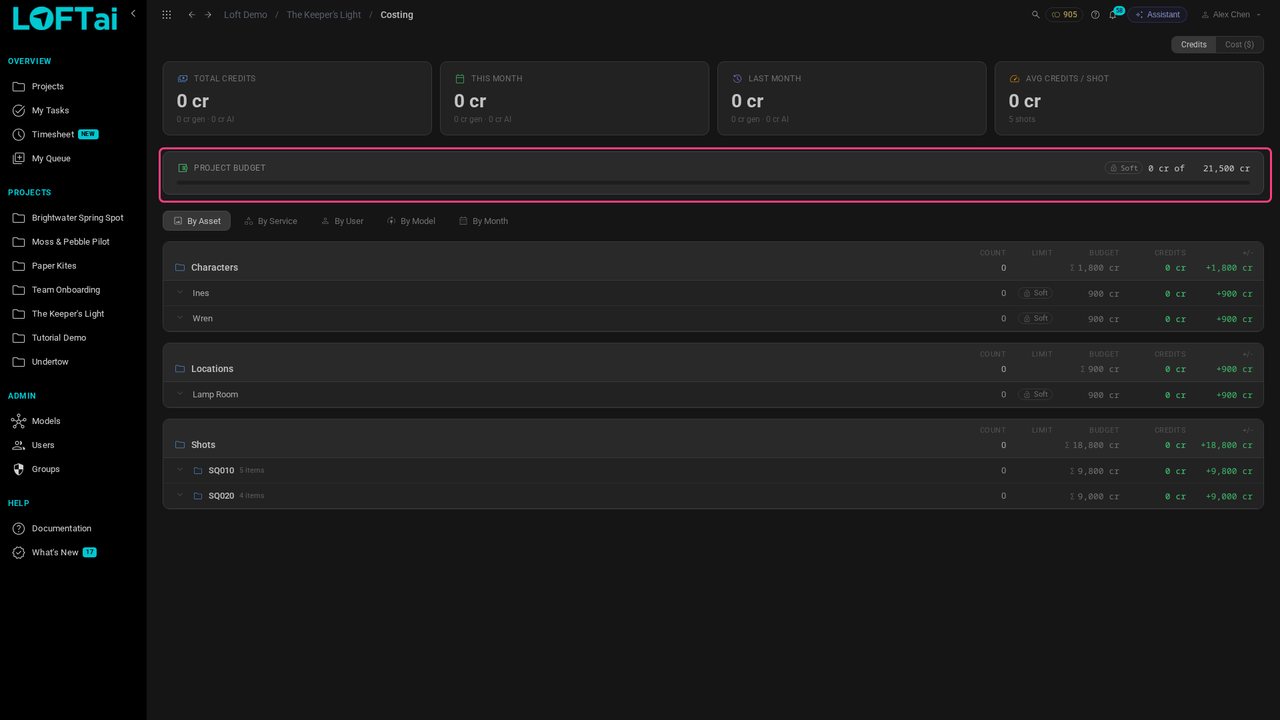

Open Costing
STEP 09

The project budget

The Project Budget is the bid's total. It is Soft: spend past it is flagged here, but nobody is stopped. Each budget can be soft or hard; click the lock to switch.

The project budget
STEP 10

Budgets per shot

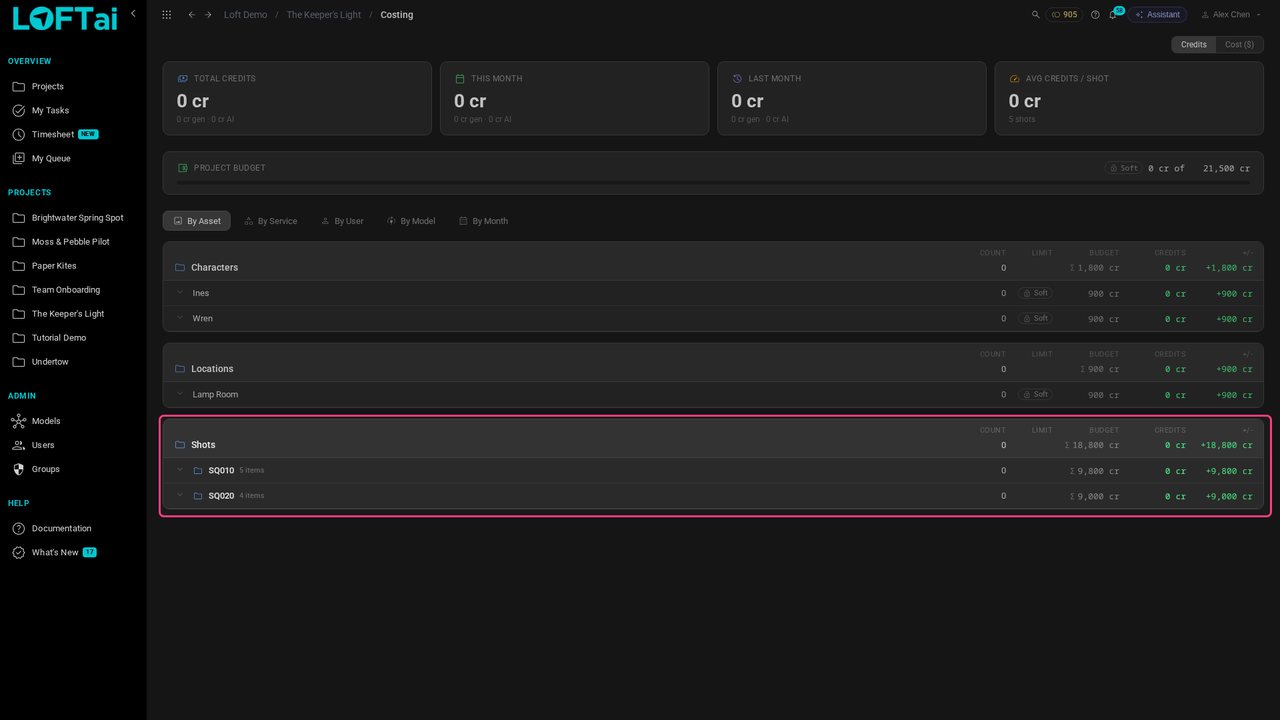

By Asset lists the budgets the bid gave each shot, character and location, rolled up by sequence, with what is spent and what is left.

Budgets per shot
STEP 11

Open By User

Click By User. Everyone working on the show is listed, with what they have spent and their allowance, so you can set one before anyone starts.

Open By User
STEP 12

Give Zoe an allowance

Click + budget on Zoe Park's row and type 6000. Zoe generates the first sequence's video, the biggest spend on the show.

Give Zoe an allowance
STEP 13

Make it a hard limit

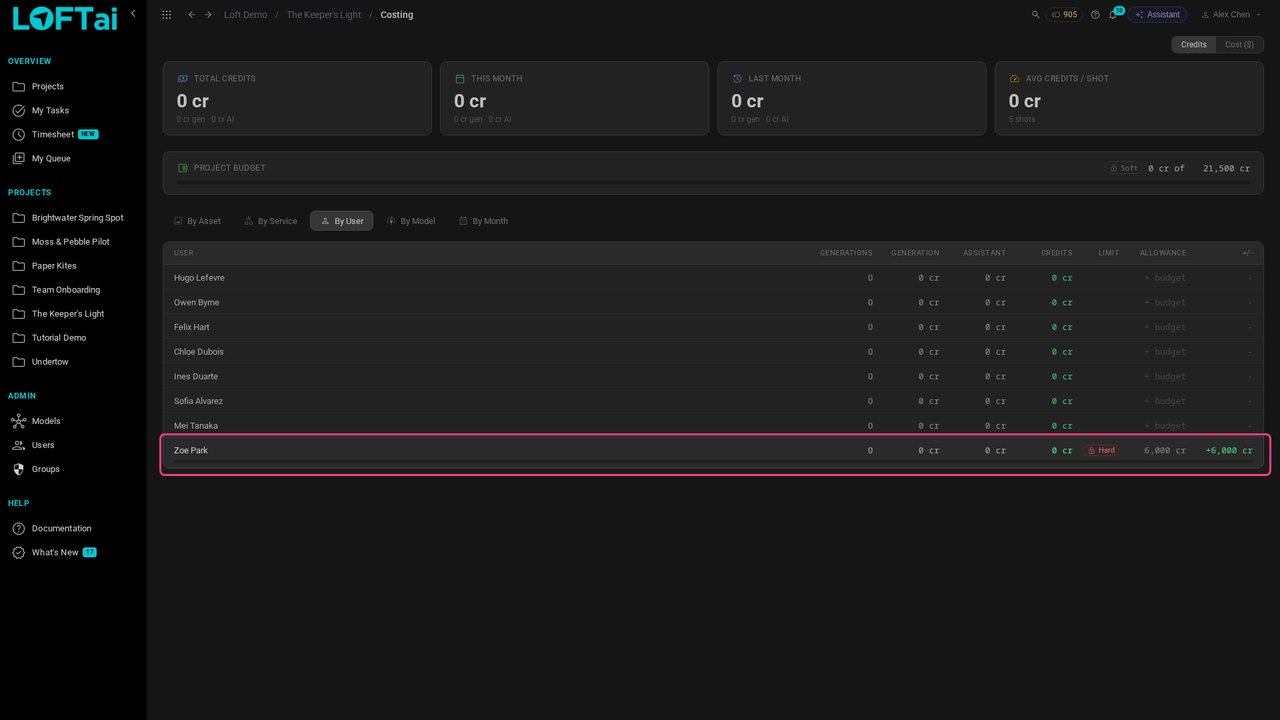

Click Soft on her row. It turns Hard: a generation that would take Zoe past 6,000 tokens is refused, until a manager raises it.

Make it a hard limit
STEP 14

Three weeks later

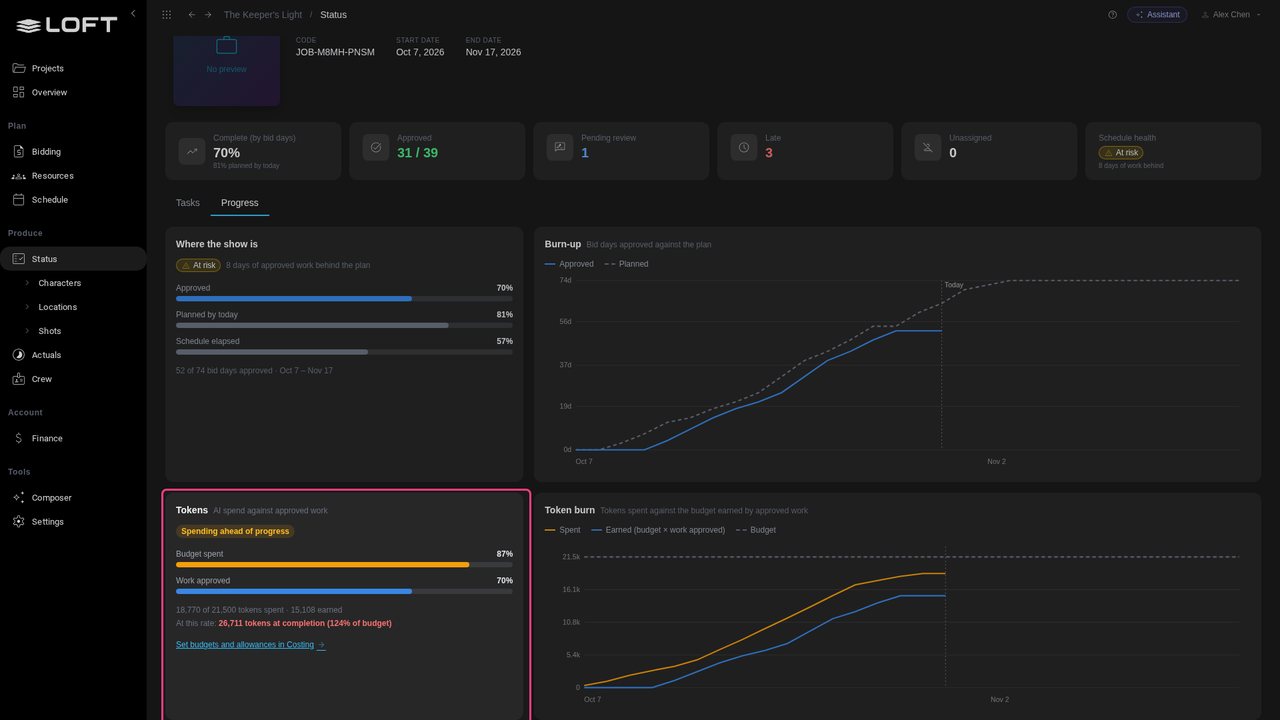

Three weeks into production, back on Status > Progress. The Tokens card says the show is spending ahead of progress: 87% of the budget is spent, but only 70% of the work is approved.

Three weeks later
STEP 15

The forecast

At the rate the approved work spent, the show finishes at about 27,000 tokens: 124% of its budget. Better to know in week three than in week six.

The forecast
STEP 16

Read the token burn

The Token burn chart: orange is tokens spent, blue is what the approved work was budgeted to cost. The gap opened with the video takes.

Read the token burn
STEP 17

Who spent it

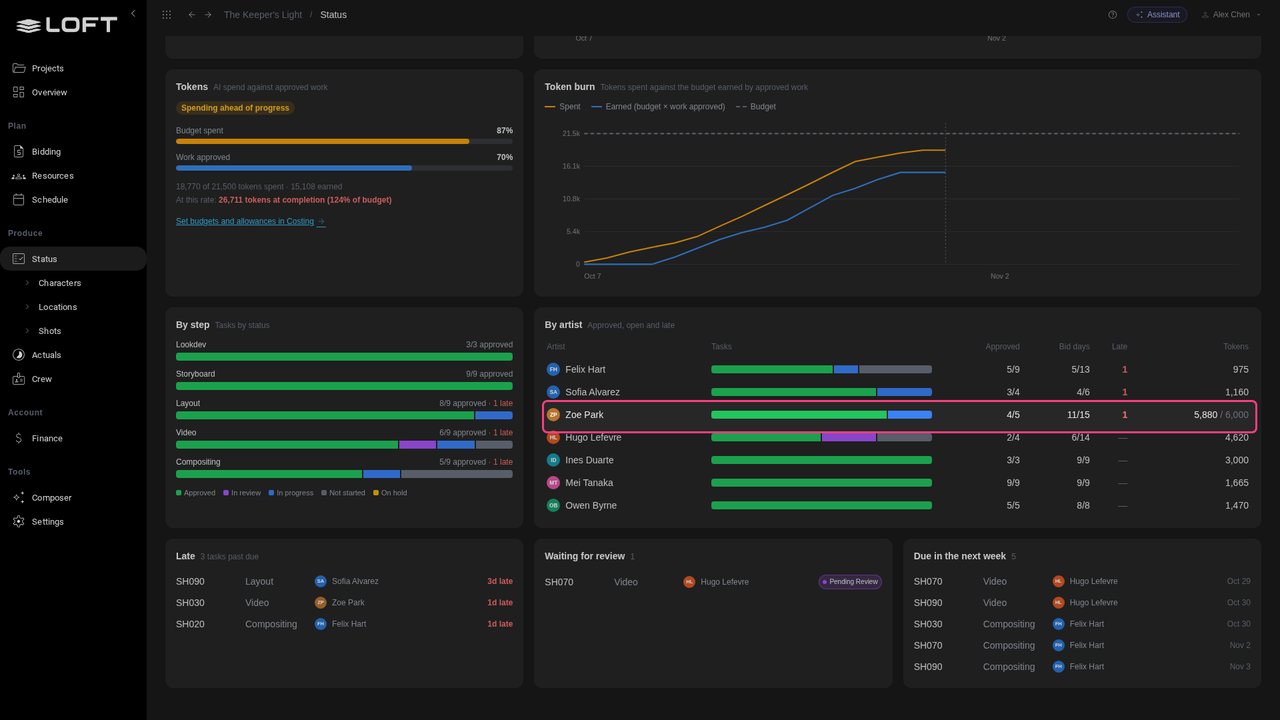

Under By artist, the Tokens column shows each person's spend. Zoe Park is at 5,880 of her 6,000.

Who spent it
STEP 18

Zoe redoes SH030

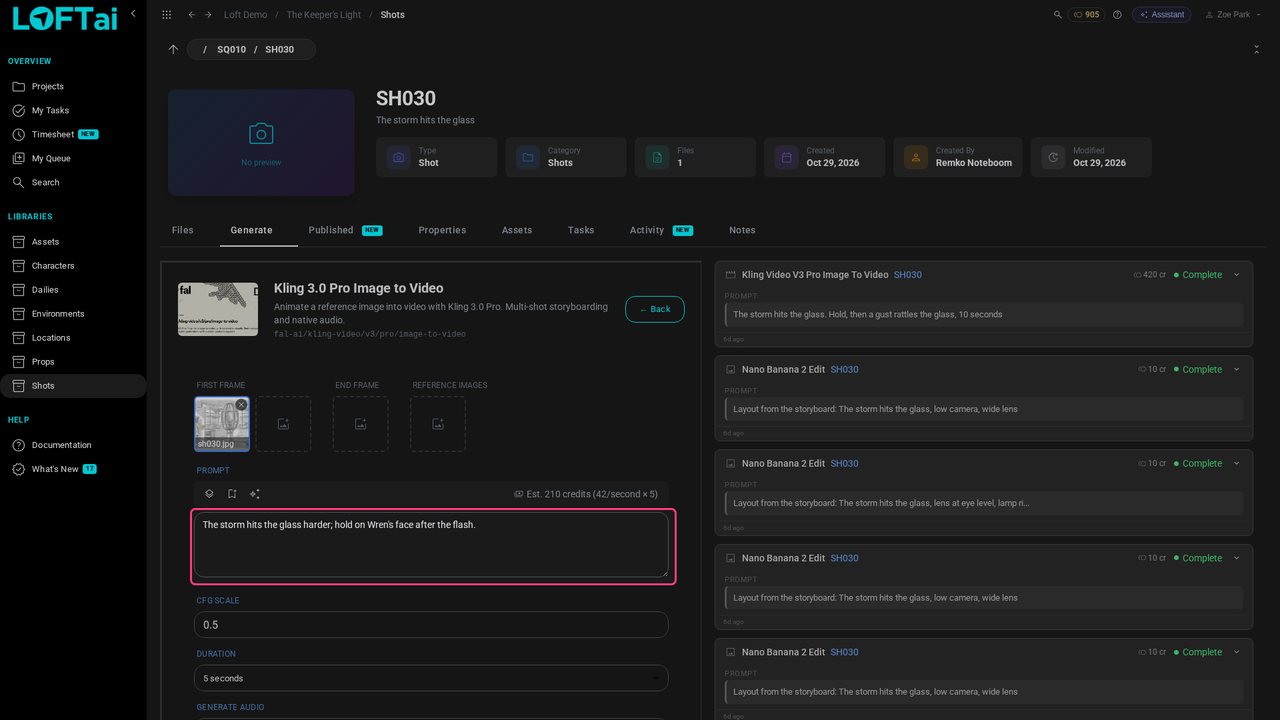

Now as Zoe. The director sent SH030's video back: the storm needs to hit the glass harder. She opens the shot, Generate, Kling 3.0 Pro Image to Video, with the storyboard as the first frame.

Zoe redoes SH030
STEP 19

Refused

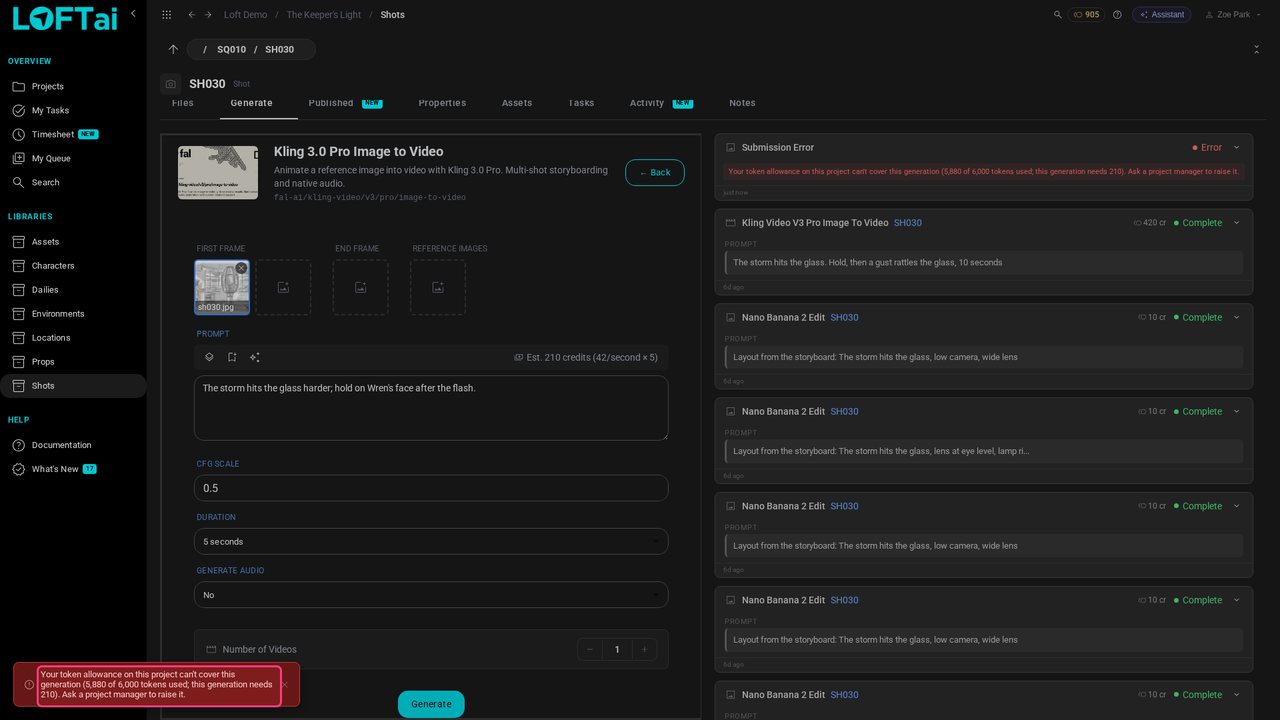

Click Generate. The take needs 210 tokens and Zoe has 120 left, so it is refused before it runs, with the reason and who can change it. Nothing was spent.

Refused
STEP 20

Ask the Assistant

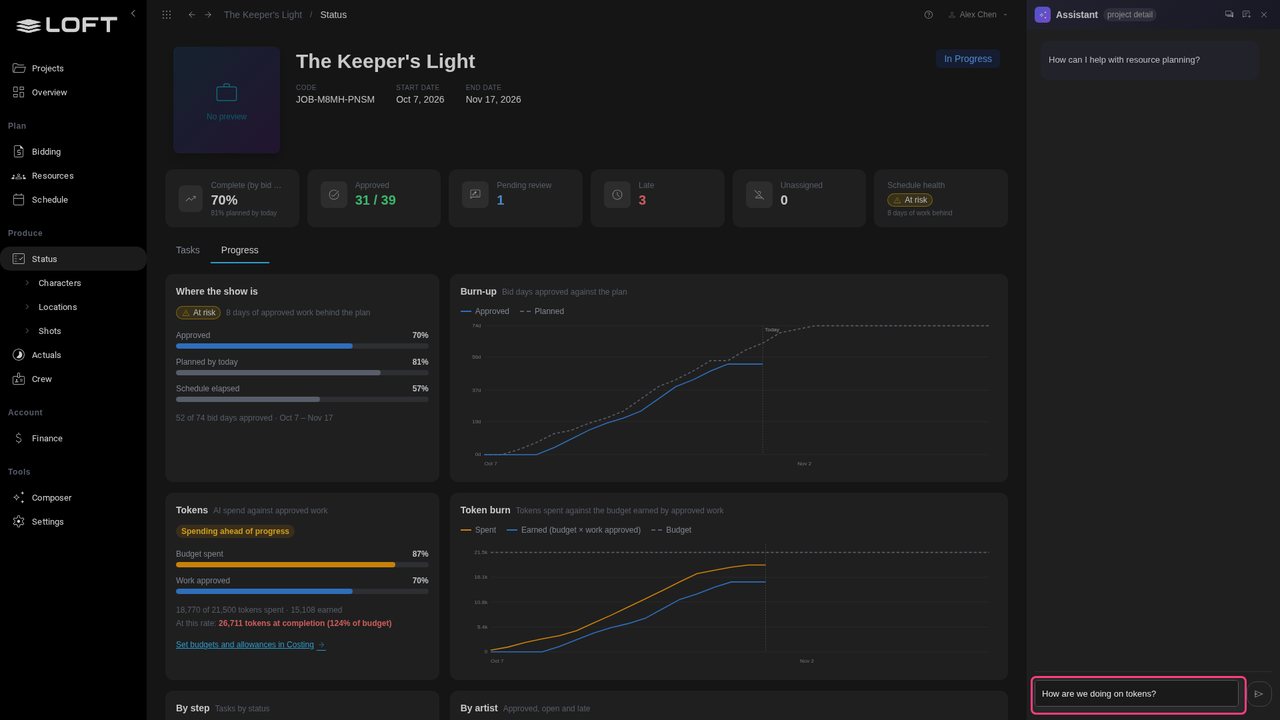

Back as the producer, on Status. Open the Assistant and ask: How are we doing on tokens?

Ask the Assistant
STEP 21

The answer

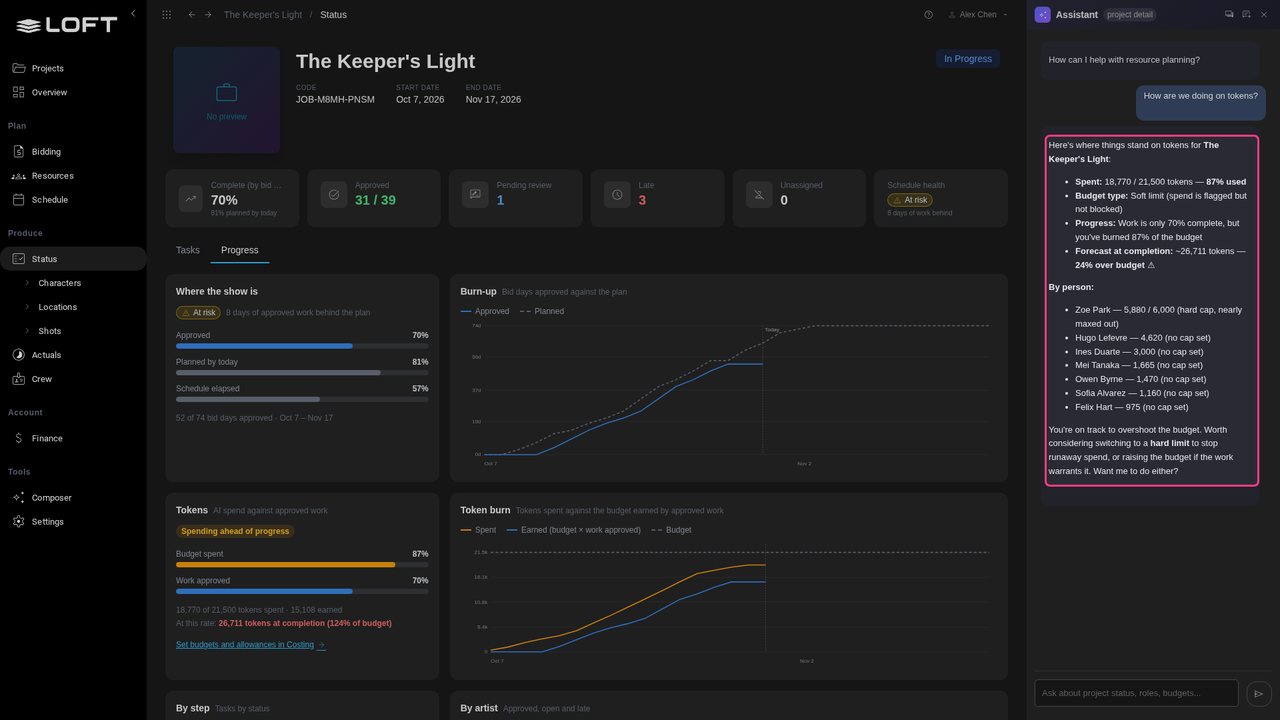

It reads the same figures: spend against the budget, what the approved work earned, the forecast, and Zoe at her limit.

The answer
STEP 22

Raise Zoe's allowance

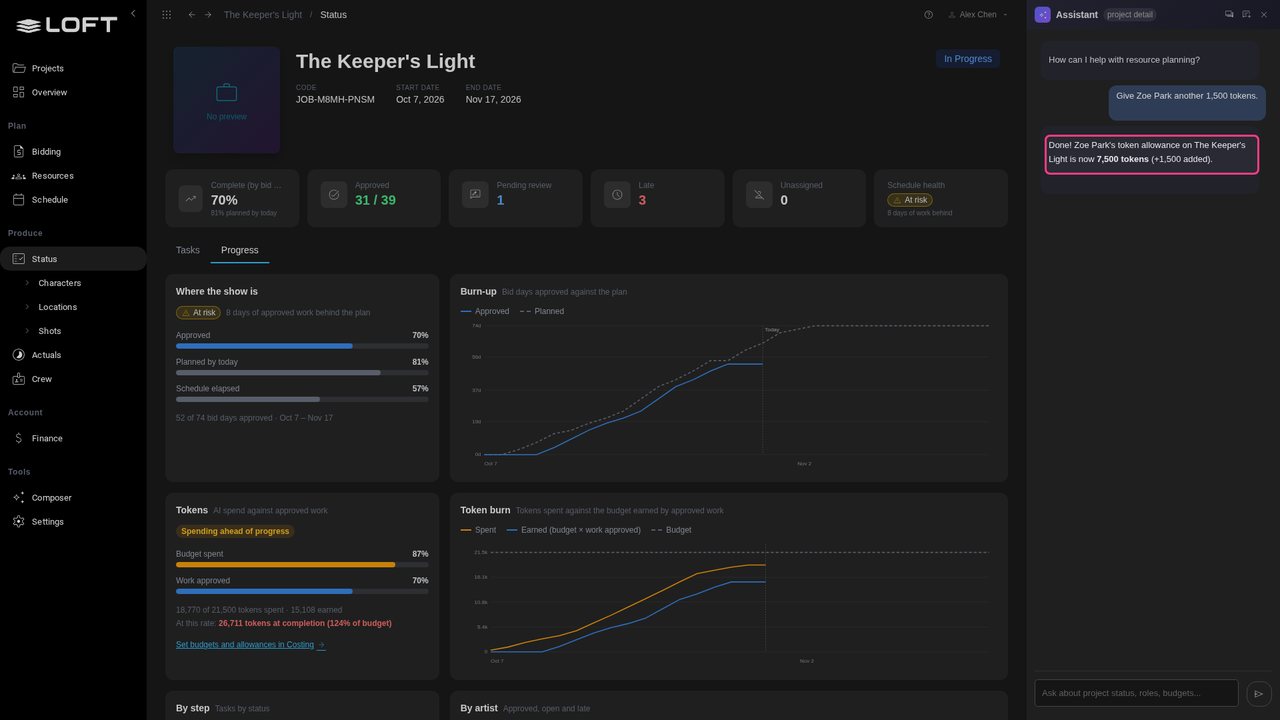

SH030 has to be redone. Ask: Give Zoe Park another 1,500 tokens. The allowance becomes 7,500 and Zoe can generate again.

Raise Zoe's allowance
STEP 23

Tokens in the P/L

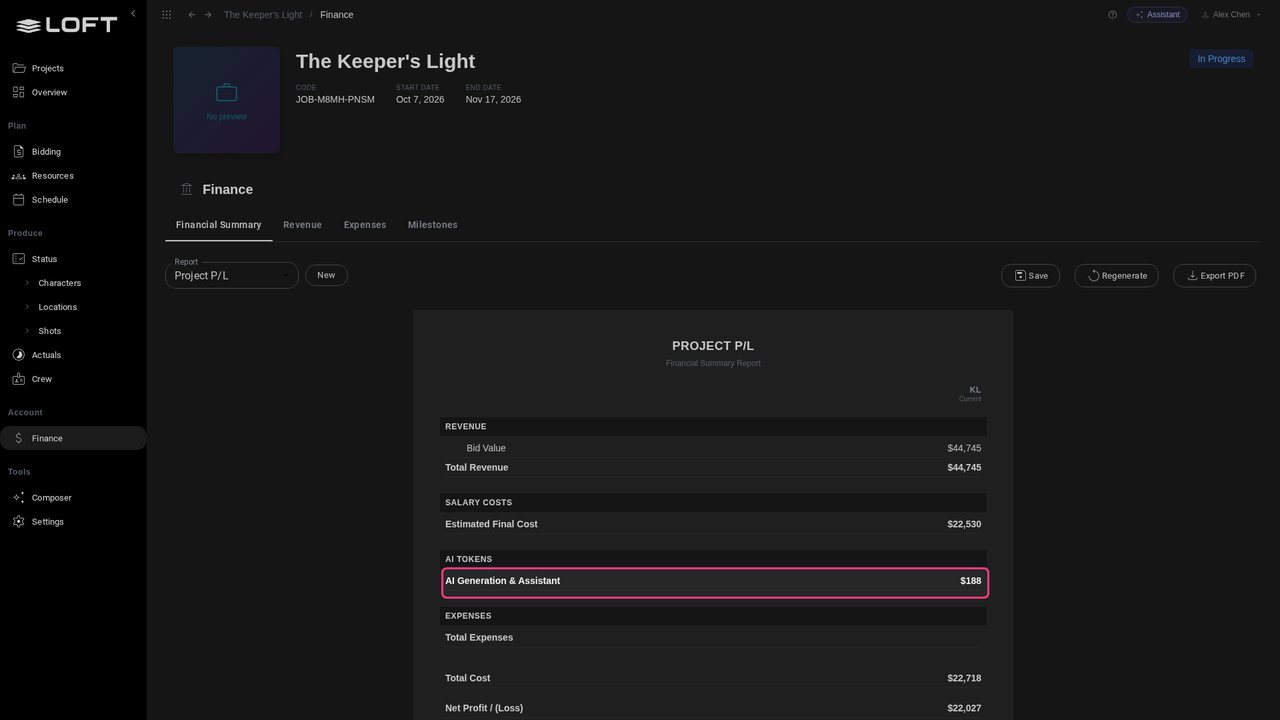

In the Account group, click Finance. The Project P/L carries the AI spend as its own line, next to labour, and the bid value includes the bid's tokens.

Tokens in the P/L
